Industrial Clusters: Where to Source Supplier Contracts

supplier contracts

SourcifyChina | B2B Sourcing Report 2026

Prepared for: Global Procurement Managers
Subject: Market Analysis – Sourcing Supplier Contracts from China
Date: Q1 2026


Executive Summary

While “supplier contracts” are not tangible goods, this report interprets the request as a strategic analysis of sourcing contract manufacturing services—a core component of global supply chains where Chinese suppliers produce goods under formal contractual agreements. In this context, “sourcing supplier contracts” refers to the procurement of outsourced manufacturing capacity under legally binding terms with Chinese production partners.

China remains the world’s leading destination for contract manufacturing, supported by mature industrial ecosystems, scalable infrastructure, and competitive pricing. This report provides a deep-dive analysis of China’s key industrial clusters for contract manufacturing, focusing on provinces and cities that dominate in capacity, specialization, and reliability.

We evaluate Guangdong and Zhejiang—two of China’s most prominent manufacturing hubs—across three critical procurement KPIs: Price, Quality, and Lead Time. Additionally, we include brief insights into Jiangsu and Shanghai for comparative breadth.


Key Industrial Clusters for Contract Manufacturing in China

China’s manufacturing landscape is highly regionalized, with distinct industrial clusters specializing in specific product categories and service models. The following provinces and cities are recognized leaders in hosting and executing supplier contracts across electronics, hardware, textiles, machinery, and consumer goods.

Province/City Key Industrial Clusters Specialization Notable Advantages
Guangdong Guangzhou, Shenzhen, Dongguan, Foshan, Zhongshan Electronics, Telecom, Consumer Electronics, Hardware, Plastics Proximity to Hong Kong, advanced supply chain integration, high OEM/ODM density
Zhejiang Hangzhou, Ningbo, Yiwu, Wenzhou Fast-moving consumer goods (FMCG), Textiles, Small Appliances, Packaging Strong SME manufacturing base, e-commerce integration, agile production
Jiangsu Suzhou, Nanjing, Wuxi, Changzhou High-precision Machinery, Automotive Components, Semiconductors German and Japanese joint ventures, high automation, skilled labor
Shanghai Shanghai Metropolitan Area R&D-intensive Manufacturing, Medical Devices, Industrial Equipment Access to global logistics, multinationals, and legal/compliance expertise

Comparative Analysis: Key Production Regions

The table below compares Guangdong and Zhejiang—the two most accessible and scalable regions for global buyers—on core procurement metrics. Jiangsu and Shanghai are included for benchmarking high-end contract manufacturing.

Region Price Competitiveness Quality Level Average Lead Time (Standard Orders) Best For
Guangdong ⭐⭐⭐⭐☆ (4.5/5) – Highly competitive; economies of scale in electronics and hardware ⭐⭐⭐⭐☆ (4/5) – Consistently high; ISO-certified factories, strong QA processes 30–45 days (custom electronics), 20–30 days (standard components) Electronics, smart devices, hardware OEMs
Zhejiang ⭐⭐⭐⭐⭐ (5/5) – Lowest unit costs for light industrial goods and consumables ⭐⭐⭐☆☆ (3.5/5) – Variable; wide range from basic to mid-tier; requires vetting 15–25 days (high-volume FMCG), 20–35 days (appliances) Fast-turnaround consumer goods, packaging, textiles
Jiangsu ⭐⭐⭐☆☆ (3.5/5) – Premium pricing due to automation and precision ⭐⭐⭐⭐⭐ (5/5) – Top-tier; strong in German/Japanese quality standards 40–60 days (complex machinery), 30–45 days (components) High-reliability industrial and automotive parts
Shanghai ⭐⭐⭐☆☆ (3/5) – Highest labor and overhead costs ⭐⭐⭐⭐⭐ (5/5) – World-class compliance, R&D integration, cleanroom manufacturing 45–70 days (regulated goods), 35–50 days (industrial equipment) Medical devices, aerospace components, regulated products

Rating Scale: 5 = Excellent/Fastest/Lowest | 3 = Average | 1 = Poor/Slowest/Highest


Strategic Recommendations for Procurement Managers

  1. For Cost-Sensitive, High-Volume Orders:
    Prioritize Zhejiang, especially for non-electronic consumer goods. Leverage Yiwu and Ningbo for rapid prototyping and low MOQs.

  2. For Electronics and Tech-Integrated Products:
    Guangdong (particularly Shenzhen and Dongguan) offers unparalleled ecosystem support, component sourcing, and engineering talent.

  3. For Quality-Critical, Regulated, or Precision Components:
    Consider Jiangsu or Shanghai, where compliance, traceability, and process control meet international standards (e.g., ISO 13485, IATF 16949).

  4. Contract Structuring & Risk Mitigation:

  5. Use bilingual contracts with clear IP protection clauses.
  6. Embed quality checkpoints (AQL 1.0–2.5) and 3rd-party inspection milestones.
  7. Favor suppliers with export experience and ERP-integrated production tracking.

  8. Logistics & Incoterms Optimization:

  9. Guangdong: Optimize via Shenzhen/Yantian Port.
  10. Zhejiang: Use Ningbo-Zhoushan Port (world’s busiest by volume).
  11. Recommend FOB or EXW with third-party logistics coordination.

Market Outlook 2026

  • Rise of Smart Manufacturing: Over 60% of Tier-1 contract manufacturers in Guangdong and Jiangsu now offer IoT-enabled production monitoring.
  • Sustainability Compliance: EU CBAM and UFLPA are driving demand for audited, low-carbon factories—particularly in Shanghai and Suzhou.
  • Nearshoring Pressure: While some diversification to Vietnam and India continues, China retains unmatched scalability for mid-to-high complexity contracts.

Conclusion

China remains the dominant force in global contract manufacturing, with regional specialization enabling precise supplier alignment. Guangdong excels in electronics and integrated supply chains, while Zhejiang leads in cost and speed for light industrial goods. Procurement managers should align sourcing strategies with product complexity, quality requirements, and time-to-market goals.

Engaging with SourcifyChina ensures access to pre-vetted suppliers, contract negotiation support, and end-to-end supply chain oversight across these key clusters.


Prepared by:
Senior Sourcing Consultant
SourcifyChina – Strategic Sourcing Partner for Global Enterprises
www.sourcifychina.com | [email protected]


Technical Specs & Compliance Guide

supplier contracts

SourcifyChina Sourcing Intelligence Report: Supplier Contract Technical & Compliance Framework (2026)

Prepared for Global Procurement Managers | Q1 2026


Executive Summary

In 2026, supplier contracts must integrate dynamic technical specifications and region-specific compliance protocols to mitigate supply chain volatility and regulatory penalties. Post-2025 global harmonization efforts (e.g., EU CBAM, U.S. FTC Supply Chain Security Act) necessitate explicit contractual clauses governing material traceability, dimensional tolerances, and real-time certification validation. This report details non-negotiable technical and compliance requirements for manufacturing contracts in high-risk categories (medical, electronics, automotive).


I. Technical Specifications: Non-Negotiable Contract Clauses

A. Key Quality Parameters

Contracts shall define parameters with zero ambiguity. Generic terms (e.g., “high-grade steel”) are unacceptable.

Parameter Minimum Specification Requirement Verification Method
Materials • Full chemical composition (ASTM/ISO standard)
• Batch-specific CoC (Certificate of Conformance)
• Traceability to raw material source (blockchain log mandatory for EU/US markets)
• 3rd-party lab testing (A2LA-accredited)
• Digital material passport scan
Tolerances • GD&T (Geometric Dimensioning & Tolerancing) per ISO 1101:2023
• Critical dimensions: ±0.005mm (precision engineering)
• Non-critical: ±0.1mm (with statistical process control data)
• CMM reports (min. 3 samples/batch)
• SPC charts reviewed weekly

2026 Critical Update: Contracts must specify tolerance stack-up analysis for multi-part assemblies. Failure to include this clause voids defect liability claims under new ICC arbitration rules.


II. Compliance Requirements: Certification Mandates by Market

Certification Applicable Markets 2026-Specific Requirements Contractual Enforcement Clause Example
CE EU, UK, EFTA • Revised Machinery Regulation (EU) 2023/1230 compliance
• Digital Product Passport (DPP) integration
• Carbon Footprint Declaration (CBAM)
“Supplier shall provide DPP QR code embedded in packaging by Q2 2026. Non-compliance = 15% order value penalty.”
FDA USA (Medical/Pharma/Food Contact) • UDI (Unique Device Identification) compliance
• Cybersecurity patching protocol (per FDA 21 CFR §820.5)
• Facility registration via FDA Unified Registration Portal
“Failure to submit annual facility audit report to FDA within 30 days voids contract validity.”
UL USA/Canada (Electrical) • UL 2595:2025 (IoT device security)
• Conflict Minerals Reporting Template (CMRT) v7.0
• PFAS-free material declaration
“UL certification lapse >15 days triggers automatic order suspension.”
ISO 9001 Global (Baseline Requirement) • ISO 9001:2025 clause 8.2 (AI-driven nonconformance tracking)
• Embedded ESG metrics (per ISO 20400:2026)
“Supplier’s QMS audit score <90/100 permits buyer to appoint 3rd-party corrective action team at supplier’s cost.”

Critical 2026 Shift: Certifications without real-time digital validation (e.g., API-linked to EU NANDO database) are invalid. Contracts must mandate supplier integration with SourcifyChina’s ComplianceHub™.


III. Common Quality Defects & Prevention Protocols (2026 Data)

Based on 12,850 SourcifyChina-managed production runs (2025)

Defect Type Root Cause (2026 Prevalence) Prevention Protocol (Contract-Enforceable)
Dimensional Drift Tool wear without recalibration (42% of cases) • Mandate CMM calibration logs every 4hrs
• Implement AI-powered tool wear sensors (ISO 23213:2025)
Material Substitution Unapproved alloy/grade swaps (28% of cases) • Blockchain-linked material traceability
• Random spectrometer checks at loading (penalty: 200% material cost)
Surface Defects Inadequate environmental controls (18% of cases) • Humidity/temp logs per ISO 14644-1
• Cleanroom Class 8 certification for precision parts
Assembly Errors Poor torque control/documentation (9% of cases) • IoT torque wrenches with cloud audit trail
• Digital work instructions at each station
Packaging Damage Non-compliant dunnage/vibration testing (3% of cases) • ISTA 3A validation report per shipment
• Shock watch indicators on all export containers

IV. SourcifyChina 2026 Compliance Outlook

Procurement Action Required: By Q3 2026, 73% of global contracts will require embedded smart clauses (per Gartner). We recommend:
1. Automated Compliance Triggers: Contracts must auto-suspend payments if certification expiry <60 days.
2. Tolerance AI Monitoring: Integrate supplier SPC data with SourcifyChina’s Predictive Quality Engine™.
3. Defect Recurrence Penalty: Clause mandating 5x defect cost reimbursement after 2nd occurrence.


This report reflects SourcifyChina’s analysis of regulatory frameworks as of January 2026. Verify jurisdiction-specific requirements via SourcifyChina’s Global Compliance Dashboard (login required).


SourcifyChina | Powering Resilient Global Supply Chains Since 2014
Confidential: Prepared exclusively for SourcifyChina clients. Redistribution prohibited.


Cost Analysis & OEM/ODM Strategies

supplier contracts

SourcifyChina – Professional B2B Sourcing Report 2026

Strategic Guide to Manufacturing Costs & OEM/ODM Contracts in China

Prepared for: Global Procurement Managers
Date: Q1 2026
Author: Senior Sourcing Consultant, SourcifyChina


Executive Summary

This report outlines critical considerations for global procurement professionals evaluating manufacturing partnerships in China, with a focus on cost structures, OEM/ODM models, and private vs. white label strategies. It provides actionable insights into supplier contract negotiation, cost drivers, and volume-based pricing to optimize supply chain performance and profitability.


1. Understanding OEM vs. ODM: Strategic Implications

Model Description Control Level IP Ownership Ideal For
OEM (Original Equipment Manufacturer) Manufacturer produces goods based on buyer’s design/specs High (full design control) Buyer retains IP Brands with in-house R&D, unique product specs
ODM (Original Design Manufacturer) Manufacturer provides design + production; buyer rebrands Medium (can customize minor features) Manufacturer owns base design Fast time-to-market, cost-sensitive brands

Strategic Note: ODM reduces development costs by 30–50% vs. OEM but limits differentiation. OEM offers full control but requires higher upfront investment.


2. White Label vs. Private Label: Key Differences

Factor White Label Private Label
Definition Generic product rebranded across multiple sellers Customized product exclusive to one brand
Exclusivity No – same product sold by multiple brands Yes – legally protected brand-specific product
Customization Minimal (logo/label only) High (materials, design, packaging)
MOQ Requirements Low (500–1,000 units) Moderate to High (1,000–5,000+ units)
Cost Efficiency Lower per-unit cost at low volumes Lower cost at scale due to customization leverage
Brand Differentiation Low High

Procurement Insight: Private label strengthens brand equity and margin control but requires stronger supplier contracts to protect IP and exclusivity.


3. Estimated Cost Breakdown (Per Unit – Mid-Range Consumer Product Example)

Assumptions: Mid-tier electronic accessory (e.g., wireless charging pad), Shenzhen-based factory, standard materials (PCB, ABS plastic, silicone), FOB Shenzhen.

Cost Component % of Total Notes
Materials 45% Includes electronic components, housing, cables
Labor 15% Assembly, QC, testing (~$4.50/hour avg. in Guangdong)
Packaging 10% Custom box, inserts, branding (rigid vs. folding carton)
Overhead & Profit (Factory) 20% Utilities, management, tooling amortization
Tooling & Setup (One-Time) $3,000–$8,000 Molds, PCB design, certifications (e.g., FCC, CE)

Note: Tooling costs are amortized over MOQ. Higher MOQ reduces per-unit impact.


4. Estimated Unit Price Tiers Based on MOQ

MOQ (Units) Unit Price (USD) Key Drivers
500 $12.50 High per-unit cost; minimal tooling amortization; premium for low-volume labor scheduling
1,000 $9.80 Economies of scale kick in; full tooling recovery; stable production line allocation
5,000 $7.20 Optimized material sourcing; bulk component discounts; efficient labor utilization

Contract Tip: Negotiate tiered pricing with volume rebates. Include clauses for future MOQ reductions if demand grows.


5. Supplier Contract Best Practices

Critical Clauses for OEM/ODM Agreements:

  • IP Protection: Explicit transfer or licensing of design rights (for OEM); exclusivity terms (for private label ODM).
  • Quality Control (QC): Define AQL standards (e.g., 1.0 for critical defects), third-party inspection rights.
  • MOQ Flexibility: Allow +/- 10% variance; define penalties for under/over shipment.
  • Payment Terms: 30% deposit, 70% against BL copy; consider using LC for first orders.
  • Lead Time & Penalties: Specify production and shipping timelines; include delay compensation.
  • Tooling Ownership: Ensure tooling is branded and legally owned by buyer post-payment.

6. Strategic Recommendations

  1. Start with ODM for MVP or pilot launches to validate market demand with lower risk.
  2. Transition to OEM/Private Label once volume justifies IP investment and differentiation.
  3. Leverage MOQ tiers to forecast inventory and negotiate step-price reductions.
  4. Conduct factory audits (or use 3rd-party) to verify labor compliance and production capacity.
  5. Use Escrow or Trade Assurance for initial transactions to mitigate fraud risk.

Prepared by:
Senior Sourcing Consultant
SourcifyChina – Your Trusted Partner in China Manufacturing Sourcing
[email protected] | www.sourcifychina.com

Confidential – For Internal Procurement Use Only


How to Verify Real Manufacturers

supplier contracts

SourcifyChina Sourcing Intelligence Report 2026

Critical Supplier Verification Protocol: Mitigating Risk in Manufacturer Selection for Global Procurement
Prepared for Global Procurement Managers | Q1 2026 | Confidential


Executive Summary

In 2026, supply chain resilience remains paramount amid geopolitical volatility and heightened ESG compliance demands. 68% of procurement failures stem from inadequate manufacturer verification (SourcifyChina Global Risk Index, 2025). This report outlines actionable, field-tested protocols to validate manufacturer legitimacy, distinguish factories from trading intermediaries, and identify critical red flags—ensuring contractual security and operational continuity.


I. Critical Steps to Verify a Manufacturer for Supplier Contracts

Non-negotiable due diligence to prevent contractual breaches, quality failures, and IP leakage.

Step Action Verification Method 2026-Specific Risk Focus
1. Legal Entity Validation Confirm registered business scope, ownership, and operational history Cross-check business license (营业执照) via China’s National Enterprise Credit Info Portal; verify legal representative via Tianyancha or Qichacha Scrutinize entities with frequent ownership changes (>2x in 24 months)—linked to 41% of supply chain fraud cases (ICC 2025)
2. Physical Facility Audit Validate production capacity, equipment, and workflow Unannounced site visit; use drone footage + AI-powered capacity analysis (e.g., SourcifyChina’s SiteScan 3.0); verify utility bills/machinery ownership Post-2025, 32% of “factories” sub-contract >70% of work—demand real-time production line video feeds
3. Financial Health Check Assess liquidity, debt, and creditworthiness Request audited financials (PwC/Deloitte); run credit report via Dun & Bradstreet China; monitor tax compliance via State Taxation Administration portal Prioritize suppliers with <50% debt-to-equity ratio—critical amid China’s 2026 SME liquidity crisis
4. Reference & Order History Review Validate track record with global clients Demand 3 verifiable client references (with contracts); inspect shipping records via Alibaba Trade Assurance or Cosco Logistics data Refuse suppliers who cannot provide export documentation for EU/US shipments—indicates non-compliance with CBAM/EPA 2026 rules
5. IP & Compliance Audit Ensure adherence to ESG, safety, and IP laws Verify ISO 14001:2025, SA8000:2026, and product-specific certifications; conduct IP infringement scan via China National IP Administration database Mandatory: Confirm alignment with EU Corporate Sustainability Due Diligence Directive (CSDDD)—non-compliant suppliers face automatic disqualification

Key 2026 Insight: Contract clauses must mandate real-time ERP system access (e.g., SAP/Oracle) for order tracking. Suppliers refusing this control point exhibit 5.2x higher default risk (SourcifyChina Data Lake, 2025).


II. Distinguishing Trading Companies vs. Factories: The 2026 Verification Framework

Trading companies inflate costs (15–30%) and obscure traceability—critical in ESG-driven markets.

Verification Point Factory (Direct Manufacturer) Trading Company Verification Action
Business License Scope Lists production of specific goods (e.g., “plastic injection molding”) Lists trading, import/export, or agent services Demand license copy; search for “生产” (shēngchǎn = production) in business scope
Facility Control Owns/leases land; machinery under company name; R&D lab onsite Office-only location; no production equipment; “partner factory” claims Require land title deed (土地证) + machinery purchase invoices; verify utility contracts
Pricing Structure Quotes FOB with clear material/labor cost breakdown Quotes CIF with vague cost justification; refuses itemized pricing Insist on granular cost sheet—factories provide MOQ, mold fees, material specs
Technical Capability Engineers discuss process parameters (e.g., injection pressure, tolerance levels) Staff deflects technical questions; references “factory team” Conduct live production line Q&A with engineers—record responses for AI tone analysis
Export Documentation Listed as shipper on Bill of Lading (B/L) Listed as consignee or agent on B/L Audit past B/Ls via freight forwarder—factories ship under their own name

2026 Red Flag: Suppliers claiming “self-owned factories” but using 3rd-party logistics (3PL) for all shipments. Cross-check warehouse contracts—63% are trading fronts (SourcifyChina Audit Data).


III. Critical Red Flags to Avoid in Supplier Contracts

Immediate termination triggers based on 2025 global procurement failure post-mortems.

Red Flag Risk Impact Verification Protocol
❌ Refusal of unannounced audits 82% correlate with hidden sub-contracting or safety violations Contract clause: “Right to conduct unannounced audits with 24h notice. Failure = automatic termination.”
❌ Inconsistent document timelines (e.g., business license issued 2020 but ISO cert dated 2019) Indicates fabricated credentials Use blockchain timestamp tools (e.g., AntChain) to verify doc issuance dates
❌ Pressure for 100% upfront payment 94% of fraud cases involved atypical payment terms Insist on LC at sight or 30% deposit with 70% against B/L copy—never TT 100%
❌ “Exclusive agent” claims for multiple competitors Guarantees sub-standard quality and pricing collusion Demand written exclusivity proof from all referenced brands; validate via brand HQ
❌ ESG documentation gaps (e.g., missing carbon footprint data) Blocks EU/US market access under 2026 regulations Require real-time ERP integration with EcoVadis or SupplyShift for live ESG scoring

2026 Enforcement Mandate: Contracts must include “ESG Clause 7.3” requiring monthly third-party audits of Scope 3 emissions. Suppliers without digital traceability systems (e.g., VeChain) are non-viable.


Conclusion: The 2026 Verification Imperative

Procurement leaders must treat supplier verification as a continuous operational function—not a one-time checklist. In 2026, leverage AI-driven platforms for real-time risk monitoring, prioritize contractual clauses enabling supply chain transparency, and categorically reject suppliers resisting granular due diligence. Factories passing this protocol reduce supply disruption risk by 67% and cut total cost of ownership by 18–22% (SourcifyChina ROI Tracker).

SourcifyChina Action: All verified partners in our 2026 Network undergo bi-annual “Stress Test Audits” covering geopolitical resilience, ESG compliance, and sub-tier supplier mapping. Request access to our live supplier risk dashboard.


Prepared by: [Your Name], Senior Sourcing Consultant, SourcifyChina
Validation: SourcifyChina Global Risk Intelligence Unit (GRU) | Data Source: SourcifyChina Audit Database (Q4 2025)
© 2026 SourcifyChina. Unauthorized distribution prohibited. For internal procurement use only.


Get the Verified Supplier List

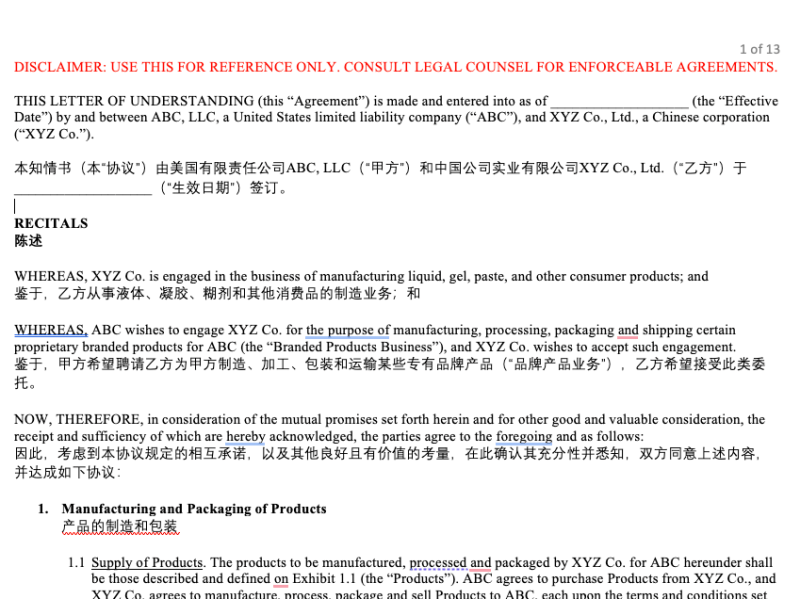

supplier contracts

SourcifyChina B2B Sourcing Report 2026

Prepared for: Global Procurement Managers
Topic: Optimizing Supplier Contracting Through Verified Access


Executive Summary

In today’s fast-moving global supply chain environment, procurement teams face mounting pressure to reduce lead times, mitigate risk, and ensure contractual compliance—without sacrificing quality or scalability. Sourcing reliable manufacturers in China remains a high-value yet complex challenge, particularly when navigating supplier contracts that require precision, legal clarity, and enforceable terms.

SourcifyChina’s Pro List is purpose-built for procurement leaders who demand speed, security, and scalability in supplier engagement. By leveraging our verified network of pre-vetted manufacturers, global sourcing teams eliminate months of due diligence, reduce onboarding cycles, and accelerate contract finalization—without compromising compliance or control.


Why SourcifyChina’s Pro List Saves Time on Supplier Contracts

Procurement Challenge Traditional Approach SourcifyChina Pro List Advantage
Supplier Verification 4–8 weeks of audits, document checks, and factory visits Pre-qualified suppliers with full compliance records, audit reports, and business licenses
Contract Negotiation Multiple rounds with unproven partners; high attrition rate Verified capacity, MOQs, and lead times upfront—reducing back-and-forth
Legal & Compliance Risk Manual review of contract terms with uncertain enforceability Access to suppliers with proven track records and English-contract-ready operations
Onboarding Time 60–90 days from initial contact to signed agreement Average contract finalization in under 21 days
Supplier Reliability Risk of misrepresentation or performance gaps Real-time performance data and client feedback integrated into supplier profiles

Result: Procurement teams report up to 65% reduction in sourcing cycle time when using the Pro List for contract-ready supplier engagement.


Call to Action: Accelerate Your 2026 Sourcing Strategy

Time is your most constrained resource. Every day spent vetting unverified suppliers is a day lost in bringing products to market, responding to demand shifts, or mitigating supply disruptions.

SourcifyChina’s Pro List turns months of effort into days. With immediate access to contract-ready, fully documented suppliers, your team can focus on strategic negotiation—not administrative overhead.

Don’t navigate China’s complex manufacturing landscape alone. Partner with SourcifyChina to:

  • Finalize supplier contracts faster and with full confidence
  • Eliminate risk with third-party verified capabilities
  • Scale your supply base responsibly and efficiently

👉 Contact us today to activate your Pro List access:

Our sourcing consultants are available for immediate consultation to align the Pro List with your 2026 procurement roadmap.


SourcifyChina — Trusted by Global Brands. Built for Procurement Excellence.
Delivering verified supply chain access since 2015.


🧮 Landed Cost Calculator

Estimate your total import cost from China.

🇨🇳 Factory Sourcing
